МАСЛЯНЫЙ НАСОС УСТАНОВКА

PROCEDURE

  1. INSTALL TIMING CHAIN CASE OIL SEAL

    A01W87IC01
    *a No Clearance

    1. Using SST and a hammer, tap in a new timing chain case oil seal until its surface is flush with the edge of the timing chain cover sub-assembly.

      SST
      09223-75010   ( 09951-07100 )

      Note

      • Keep the lip free from foreign matter.

      • Do not tap the timing chain case oil seal at an angle.

    2. Apply MP grease to the lip of the timing chain case oil seal.

  2. INSTALL ENGINE WATER PUMP ASSEMBLY

    1. Install a new gasket and the engine water pump assembly with the 8 bolts.

      Torque:
      13 N*m  { 133 kgf*cm, 10 ft.*lbf }
  3. INSTALL TIMING CHAIN COVER SUB-ASSEMBLY

    1. Install 3 new O-rings to the timing chain cover sub-assembly.

    2. Clean and degrease the contact surfaces of the timing chain cover sub-assembly, cylinder head sub-assembly and cylinder block sub-assembly.

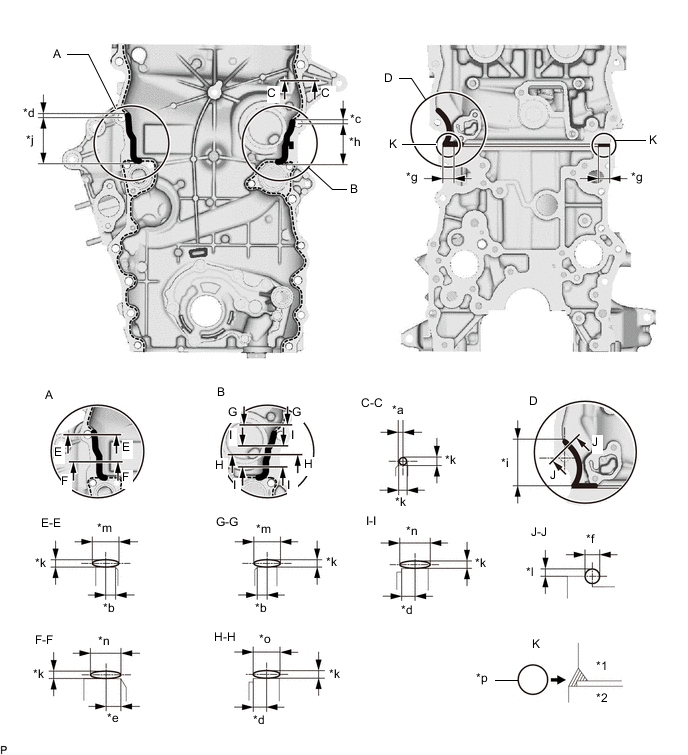

    3. Apply seal packing to the timing chain cover sub-assembly in a continuous line as shown in the following illustration.

      Seal packing
      Toyota Genuine Seal Packing Black, Three Bond 1207B or equivalent
      A01W8R5C01
      *1 Cylinder Head Sub-assembly *2 Cylinder Block Sub-assembly
      *a 2.0 mm (0.0787 in.) *b 2.5 mm (0.0984 in.)
      *c 5.0 mm (0.197 in.) *d 6.0 mm (0.236 in.)
      *e 7.0 mm (0.276 in.) *f 8.0 mm (0.315 in.) or more
      *g 20 mm (0.787 in.) *h 54 mm (2.13 in.)
      *i 56.5 mm (2.22 in.) *j 58 mm (2.28 in.)
      *k 2.5 to 4.0 mm (0.0984 to 0.157 in.) *l 5.0 to 6.0 mm (0.197 to 0.236 in.)
      *m 9.0 to 13 mm (0.354 to 0.512 in.) *n 10 to 14 mm (0.394 to 0.551 in.)
      *o 12 to 16 mm (0.472 to 0.630 in.) *p Seal Packing

      Note

      • Remove any oil from the contact surface.

      • When the contact surfaces are wet, wipe them with an oil-free cloth before applying seal packing.

      • Install the timing chain cover sub-assembly within 3 minutes and tighten the bolts within 10 minutes after applying seal packing.

      • Do not start the engine for at least 4 hours after the installation.

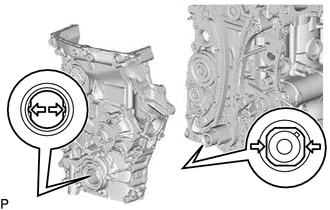

    4. A01W9BB

      Align the width of the joint portion of the oil pump drive rotor and the crankshaft timing gear, and then install the timing chain cover sub-assembly.

    5. w/ Air Conditioning System:

      Temporarily install the timing chain cover sub-assembly with the 16 bolts and nut.

      A01WA4HC01
      *a Types of nut and bolt *b Tightening order
      B0027PX Bolt B0027QD Nut
      Torque:
      for bolt A
      57 N*m  { 581 kgf*cm, 42 ft.*lbf }
      for bolt B and nut
      23 N*m  { 235 kgf*cm, 17 ft.*lbf }
      for bolt C
      21 N*m  { 214 kgf*cm, 15 ft.*lbf }
      for bolt D
      25 N*m  { 255 kgf*cm, 18 ft.*lbf }
      Bolt Length
      Item Length Thread Diameter
      Bolt A 75 mm (2.95 in.) 10 mm (0.394 in.)
      Bolt B 75 mm (2.95 in.) 8.0 mm (0.315 in.)
      Bolt C 40 mm (1.57 in.) 8.0 mm (0.315 in.)
      Bolt D 90 mm (3.54 in.) 8.0 mm (0.315 in.)

      Note

      • Make sure that there is no oil on the threads of bolts.

      • Check the bolts and bolt holes, and clean and degrease them.

    6. w/o Air Conditioning System:

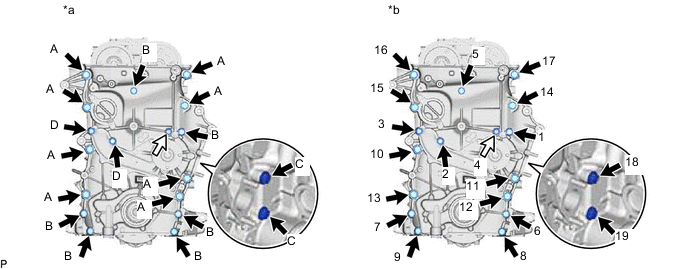

      Temporarily install the timing chain cover sub-assembly with the 18 bolts and nut.

      A01WBS1C01
      *a Types of nut and bolt *b Tightening order
      B0027PX Bolt B0027QD Nut
      Torque:
      for bolt A
      57 N*m  { 581 kgf*cm, 42 ft.*lbf }
      for bolt B and nut
      23 N*m  { 235 kgf*cm, 17 ft.*lbf }
      for bolt C
      21 N*m  { 214 kgf*cm, 15 ft.*lbf }
      for bolt D
      25 N*m  { 255 kgf*cm, 18 ft.*lbf }
      Bolt Length
      Item Length Thread Diameter
      Bolt A 75 mm (2.95 in.) 10 mm (0.394 in.)
      Bolt B 75 mm (2.95 in.) 8.0 mm (0.315 in.)
      Bolt C 40 mm (1.57 in.) 8.0 mm (0.315 in.)
      Bolt D 90 mm (3.54 in.) 8.0 mm (0.315 in.)

      Note

      • Make sure that there is no oil on the threads of bolts.

      • Check the bolts and bolt holes, and clean and degrease them.

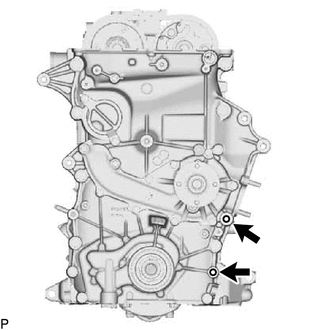

    7. A01WBT5

      w/ Air Conditioning System:

      Remove the seal packing from the 2 bolt holes for the No. 1 compressor mounting bracket.

      Note

      Do not use any cleaners to remove the seal packing.

  4. INSTALL CRANKSHAFT POSITION SENSOR

    Click here

  5. INSTALL OIL PAN SUB-ASSEMBLY

    1. Clean and degrease the contact surfaces of the oil pan sub-assembly and cylinder block sub-assembly.

    2. A01W8VBC01
      *a Seal Packing
      *b 8.0 mm (0.315 in.)
      *c 6.5 mm (0.256 in.)

      Apply seal packing in a continuous line as shown in the illustration.

      Seal packing
      Toyota Genuine Seal Packing Black, Three Bond 1207B or equivalent
      Application Specification
      Area Seal Packing Diameter Distance from Edge of Cover or Center of Bolt Hole to Center of Seal Packing
      A - A and C - C 2.0 to 3.0 mm (0.0787 to 0.118 in.) 8.0 mm (0.315 in.)
      B - B 2.0 to 3.0 mm (0.0787 to 0.118 in.) 6.5 mm (0.256 in.)

      Note

      • Remove any oil from the contact surface.

      • Install the oil pan sub-assembly within 3 minutes and tighten the bolts within 10 minutes after applying seal packing.

      • Do not start the engine for at least 4 hours after the installation.

    3. A01W8JJC01
      B0027PX Bolt A
      B0027QD Bolt B
      B0028TO Nut

      Temporarily install the oil pan sub-assembly with the 16 bolts and 2 nuts.

      Bolt Length
      Item Length
      Bolt A 20 mm (0.787 in.)
      Bolt B 40 mm (1.57 in.)
    4. Uniformly tighten the 16 bolts and 2 nuts in the order shown in the illustration.

      Torque:
      26 N*m  { 265 kgf*cm, 19 ft.*lbf }
  6. INSTALL OIL STRAINER SUB-ASSEMBLY

    1. A01W8USC01
      *a Protrusion
      *b Groove

      Install a new gasket to the oil strainer sub-assembly.

      Tech Tips

      Align the protrusion of the gasket with the groove of the oil strainer sub-assembly.

    2. A01W8LSN01

      Install the oil strainer sub-assembly with the 2 bolts and nut in the sequence shown in the illustration.

      Torque:
      10 N*m  { 102 kgf*cm, 7 ft.*lbf }
  7. INSTALL NO. 2 OIL PAN SUB-ASSEMBLY

    1. Clean and degrease the contact surfaces of the oil pan sub-assembly and No. 2 oil pan sub-assembly.

    2. A01WA8VC01
      *a Seal Packing
      *b 6.0 mm (0.236 in.)

      Apply seal packing in a continuous line as shown in the illustration.

      Seal packing
      Toyota Genuine Seal Packing Black, Three Bond 1207B or equivalent
      Application Specification
      Seal Packing Diameter Distance from Center of Bolt Hole to Center of Seal Packing
      2.5 to 3.5 mm (0.0984 to 0.138 in.) 6.0 mm (0.236 in.)

      Note

      • Remove any oil from the contact surface.

      • Install the No. 2 oil pan sub-assembly within 3 minutes and tighten the bolts within 10 minutes after applying seal packing.

      • Do not start the engine for at least 4 hours after the installation.

    3. Temporarily install the No. 2 oil pan sub-assembly with the 16 bolts, 4 adjusting screws and 2 nuts.

    4. A01WBJVC01
      B0027PX Bolt
      B0027QD Nut
      B0028TO Adjusting Screw

      Uniformly tighten the 16 bolts, 4 adjusting screws and 2 nuts in the order shown in the illustration.

      Torque:
      9.0 N*m  { 92 kgf*cm, 80 in.*lbf }
    5. Install a new gasket and the oil pan drain plug.

      Torque:
      37.5 N*m  { 382 kgf*cm, 28 ft.*lbf }
  8. INSTALL OIL PAN COVER SILENCER

    1. Install the oil pan cover silencer with the 4 No. 1 oil pan plugs.

      Torque:
      7.0 N*m  { 71 kgf*cm, 62 in.*lbf }
  9. INSTALL CRANKSHAFT PULLEY

    1. A01W9LZC01
      *a Hold
      B0027PX Turn

      Align the key groove of the crankshaft pulley with the pulley set key and slide on the crankshaft pulley.

    2. Using SST, install a new crankshaft pulley set bolt.

      SST
      09213-54015   ( 91651-60855 )
      09330-00021
      Torque:
      260 N*m  { 2651 kgf*cm, 192 ft.*lbf }

      Note

      Do not reuse the crankshaft pulley set bolt.

  10. INSTALL CYLINDER HEAD COVER SUB-ASSEMBLY

    1. Clean and degrease the contact surfaces of the timing chain cover sub-assembly, cylinder head and cylinder head cover sub-assembly.

    2. A01W8HLC01
      B0027PX Seal Packing Application Area

      Apply seal packing as shown in the illustration.

      Seal packing
      Toyota Genuine Seal Packing Black, Three Bond 1207B or equivalent
      Seal packing diameter
      4.0 mm (0.157 in.)

      Note

      • Remove any oil from the contact surface.

      • Install the cylinder head cover sub-assembly within 3 minutes and tighten the bolts within 10 minutes after applying seal packing.

      • Do not add the engine oil for at least 4 hours after the installation.

      • Do not start the engine for at least 4 hours after the installation.

    3. Install a new No. 1 camshaft bearing cap oil hole gasket to the cylinder head cover connector sub-assembly.

    4. Install a new cylinder head cover gasket to the cylinder head cover sub-assembly.

    5. A01WAFSC02
      *a Plate Washer and Seal Washer
      B0027PX Bolt
      B0027QD Nut

      Install the cylinder head cover sub-assembly, 2 plate washers and 2 seal washers with the 21 bolts and 2 nuts, and tighten the 21 bolts and 2 nuts in the sequence shown in the illustration.

      Torque:
      9.0 N*m  { 92 kgf*cm, 80 in.*lbf }

      Note

      Make sure that the metal face of the seal washer is facing upward.

  11. INSTALL CAMSHAFT TIMING OIL CONTROL VALVE ASSEMBLY (for Exhaust Side)

    Click here

  12. INSTALL CAMSHAFT POSITION SENSOR (for Exhaust Side)

    Click here

  13. INSTALL CAMSHAFT POSITION SENSOR (for Intake Side)

    Click here

  14. INSTALL OIL FILLER CAP SUB-ASSEMBLY

    Click here

  15. INSTALL NO. 1 WATER BY-PASS PIPE

    Click here

  16. INSTALL NO. 1 IDLER PULLEY SUB-ASSEMBLY

    Click here

  17. INSTALL V-RIBBED BELT TENSIONER ASSEMBLY

    Click here

  18. INSTALL THERMOSTAT

    Click here

  19. INSTALL WATER INLET

    Click here

  20. INSTALL NO. 1 COMPRESSOR MOUNTING BRACKET (w/ Air Conditioning System)

    Click here

  21. INSTALL GENERATOR ASSEMBLY

    Click here

  22. INSTALL INTAKE MANIFOLD

    Click here

  23. INSTALL FUEL INJECTOR ASSEMBLY

    Click here

  24. INSTALL FUEL DELIVERY PIPE

    Click here

  25. INSTALL THROTTLE BODY WITH MOTOR ASSEMBLY

    Click here

  26. INSTALL PCV PIPE

    Click here

  27. INSTALL SPARK PLUG

    Click here

  28. INSTALL IGNITION COIL ASSEMBLY

    Click here

  29. REMOVE ENGINE FROM ENGINE STAND

    Click here

  30. INSTALL ENGINE ASSEMBLY

    Click here
